We need to make these sites into assets for the community. Many of these developments are causing real hazards for their neighbors, with fences falling down on sidewalks, loose construction debris that can become deadly in high winds, and unsecured sites that are dangerous for children and an invitation to squatting.
Help the effort to convert local blight to community benefit by providing feedback and tracking the progress of each site.
Leave comments below on a individual site to update us on the conditions. If you call 311 about an issue, please leave a complaint number in the comment.
Friday, August 20, 2010
Tuesday, June 1, 2010
333 Carroll Street, Carroll Gardens
(between Hoyt and Bond Streets)
Project Type: Existing building
Project Description: Conversion of manufacturing building to residential, with additional floors built
Status: Frozen with vertical extension incomplete, Stop Work Order in effect
UPDATE: DOB adds to "Stalled Sites" list for extra monitoring: 2/16/2010

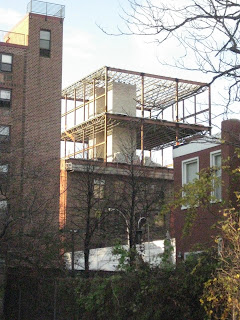

Background: The plan, initiated in 2005, was to convert and enlarge a historic manufacturing building to condos. The design was by architect Robert Scarano. The building was controversial because of its height and the impact on a landmarked block. The design was also challenged, as extensions that the architect called mezzanines were challenged as illegally expanding the permitted Floor Area Ratio. The DOB agreed and a Stop Work Order was issued in September 2006. Scarano was removed from the project and replaced by Karl Fischer. Permits expired, and after they were renewed, another SWO was issued because of after-hours work. There has been no activity since March 2008.
The project – nicknamed by blogs as the "Hell Building" – contributed to community demand for a downzoning. The Carroll Gardens/Columbia Waterfront Contextual Rezoning was approved in October 2009, and the DOB determined that the project was only 15% complete. Therefore, the project was not sufficiently advanced to be grandfathered under the previous zoning and construction was ordered ceased. The steel structure of the top floors remains but cannot be completed, and although permits are current the owner has not indicated when/if he will amend plans and remove the non-compliant structure.
Project Type: Existing building
Project Description: Conversion of manufacturing building to residential, with additional floors built
Status: Frozen with vertical extension incomplete, Stop Work Order in effect
UPDATE: DOB adds to "Stalled Sites" list for extra monitoring: 2/16/2010
Background: The plan, initiated in 2005, was to convert and enlarge a historic manufacturing building to condos. The design was by architect Robert Scarano. The building was controversial because of its height and the impact on a landmarked block. The design was also challenged, as extensions that the architect called mezzanines were challenged as illegally expanding the permitted Floor Area Ratio. The DOB agreed and a Stop Work Order was issued in September 2006. Scarano was removed from the project and replaced by Karl Fischer. Permits expired, and after they were renewed, another SWO was issued because of after-hours work. There has been no activity since March 2008.
The project – nicknamed by blogs as the "Hell Building" – contributed to community demand for a downzoning. The Carroll Gardens/Columbia Waterfront Contextual Rezoning was approved in October 2009, and the DOB determined that the project was only 15% complete. Therefore, the project was not sufficiently advanced to be grandfathered under the previous zoning and construction was ordered ceased. The steel structure of the top floors remains but cannot be completed, and although permits are current the owner has not indicated when/if he will amend plans and remove the non-compliant structure.
824 Friel Place, Kensington
(between East 8th Street and Coney Island Avenue)
Project Type: Existing building/renovation
Project Description: Rehabilitation of a 2 family home
Status: Open pit, no activity
UPDATE: DOB adds to "Stalled Sites" list for extra monitoring: 2/16/2010
Background: As a result of a tax foreclosure, the City took possesion of this 1-family home in 1990. In 2005, Just Homes LLC, a small developer, bought this property from the City and the Community Preservation Corporation as part of an affordable housing program. Plans for renovation and expansion of the building were approved in 2005 and amended in 2007, but there is no indication of a demolition permit. The building was either demolished or decayed, and all that remains are a pit with partial cement walls and a stoop that leads to nowhere.
Until recently, there was no construction fence, so access was open. A homeless veteran has been living in the pit. The Land Disposition Agreement between the City and Just Homes states the terms for default, which include failure to complete construction within a reasonable time period. There are 24 outstanding violations, but the site is not formally classified by the DOB as Stalled.
Councilmember Lander's office intervened, and now there is a new plywood fence and Common Ground's Street Outreach Program (funded by the City's Department of Homeless Services) arranged for a shelter placement and services for the homeless veteran. The property will be developed as part of an HPD affordable housing program.
Project Type: Existing building/renovation
Project Description: Rehabilitation of a 2 family home
Status: Open pit, no activity
UPDATE: DOB adds to "Stalled Sites" list for extra monitoring: 2/16/2010
Background: As a result of a tax foreclosure, the City took possesion of this 1-family home in 1990. In 2005, Just Homes LLC, a small developer, bought this property from the City and the Community Preservation Corporation as part of an affordable housing program. Plans for renovation and expansion of the building were approved in 2005 and amended in 2007, but there is no indication of a demolition permit. The building was either demolished or decayed, and all that remains are a pit with partial cement walls and a stoop that leads to nowhere.
Until recently, there was no construction fence, so access was open. A homeless veteran has been living in the pit. The Land Disposition Agreement between the City and Just Homes states the terms for default, which include failure to complete construction within a reasonable time period. There are 24 outstanding violations, but the site is not formally classified by the DOB as Stalled.
Councilmember Lander's office intervened, and now there is a new plywood fence and Common Ground's Street Outreach Program (funded by the City's Department of Homeless Services) arranged for a shelter placement and services for the homeless veteran. The property will be developed as part of an HPD affordable housing program.
174 Garfield Place, Park Slope
(between 6th and 7th Avenues)
Project type: Existing building
Project description: None (vacant building)
Status: UPDATE 8/2010: Site sold to new developer who plans on building at the site. See Brooklyn Paper article here.
UPDATE: DOB adds to "Stalled Sites" list for extra monitoring: 2/16/2010
Background: In 2006 and 2007, partial demolition work was undertaken without a permit. The work ceased, and the building was sealed. The building has 15 unresolved violations, the most recent of which indicated that the brickwork and cornice are defective and loose. There have been complaints about the building being open and accessible, but the DOB has determined that it is sufficiently closed. Windows and doors are cemented, but the front yard is open and accessible, in poor shape and has debris. Permits have expired.
Project type: Existing building
Project description: None (vacant building)
Status: UPDATE 8/2010: Site sold to new developer who plans on building at the site. See Brooklyn Paper article here.
UPDATE: DOB adds to "Stalled Sites" list for extra monitoring: 2/16/2010
Background: In 2006 and 2007, partial demolition work was undertaken without a permit. The work ceased, and the building was sealed. The building has 15 unresolved violations, the most recent of which indicated that the brickwork and cornice are defective and loose. There have been complaints about the building being open and accessible, but the DOB has determined that it is sufficiently closed. Windows and doors are cemented, but the front yard is open and accessible, in poor shape and has debris. Permits have expired.
149 Kane Street, Cobble Hill
(between Henry Street and Hicks Street)
Project Type: Existing building
Project Description: Extensive repairs required, not addressed

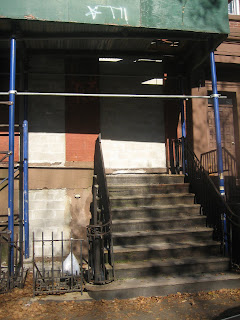

Status: Vacant and sealed
UPDATE: DOB declared "Stalled": 2/16/2010
Background: This townhouse has received 36 violations since 2005, with the vast majority due to unsafe conditions and continuing deterioration, including numerous façade cracks, a hanging cornice, cracks in the stairs, roof decking separation, and blocked exits. A full vacate order was served in May 2009 and a full Stop Work Order was served in July, with violations for failure to comply with the vacate order.
In September permit applications were filed for a full interior and exterior renovation, but the plans were disapproved. All windows and doors are cemented, a sidewalk shed is up, the scaffolding company’s sign indicates that the permit was valid 12/31/2009, but no DOB permits are posted and there is no activity.
Project Type: Existing building
Project Description: Extensive repairs required, not addressed
Status: Vacant and sealed
UPDATE: DOB declared "Stalled": 2/16/2010
Background: This townhouse has received 36 violations since 2005, with the vast majority due to unsafe conditions and continuing deterioration, including numerous façade cracks, a hanging cornice, cracks in the stairs, roof decking separation, and blocked exits. A full vacate order was served in May 2009 and a full Stop Work Order was served in July, with violations for failure to comply with the vacate order.
In September permit applications were filed for a full interior and exterior renovation, but the plans were disapproved. All windows and doors are cemented, a sidewalk shed is up, the scaffolding company’s sign indicates that the permit was valid 12/31/2009, but no DOB permits are posted and there is no activity.
100 Luquer Street, Carroll Gardens
(between Hamilton Avenue and Clinton Street)
Project Type: New building
Project Description: Construction of new 11 story, 20 unit building
Status: Stop Work Order in effect
UPDATE: DOB added to "Stalled Site" list 2/19/2010
Background: This building project started in 2005. Designed by architect Karl Fischer, 100 Luquer Street is the tallest building in the area. Neighborhood residents have cited it as out-of-context and as a factor in the 2009 downzoning. The DOB has issued 19 violations for infractions including unprotected holes in floors, components not conforming to approved plans, unlicensed riggers, unsafe scaffolding, inadequate fencing, and lack of a sidewalk shed.
The exterior is significantly complete, but activity has stopped. There have been multiple Stop Work Orders. A violation was issued in August 2009 for failure to obey a Stop Work Order. The latest permit expired in October 2009. When we visited the site in late October, fencing was intact, and though some construction equipment remained onsite, there was no activity.
Project Type: New building
Project Description: Construction of new 11 story, 20 unit building
Status: Stop Work Order in effect
UPDATE: DOB added to "Stalled Site" list 2/19/2010
Background: This building project started in 2005. Designed by architect Karl Fischer, 100 Luquer Street is the tallest building in the area. Neighborhood residents have cited it as out-of-context and as a factor in the 2009 downzoning. The DOB has issued 19 violations for infractions including unprotected holes in floors, components not conforming to approved plans, unlicensed riggers, unsafe scaffolding, inadequate fencing, and lack of a sidewalk shed.
The exterior is significantly complete, but activity has stopped. There have been multiple Stop Work Orders. A violation was issued in August 2009 for failure to obey a Stop Work Order. The latest permit expired in October 2009. When we visited the site in late October, fencing was intact, and though some construction equipment remained onsite, there was no activity.
455 12th Street, Park Slope
(between 7th and 8th Avenues)
Project Type: Existing building alteration
Project Description: Vertical enlargement, adding additional floor to 3 story, 6 family apartment building
Status: Partial Stop Work Order in effect
UPDATE: DOB adds to "Stalled Sites" list for extra monitoring: 2/16/2010
Background: Plans were filed in 2008 to add an additional floor. Gut renovations were undertaken. Violations were issued for unsafe working conditions. Inspectors noted men working on open flooring throughout the site, floors exposed and with no safety equipment. Stop Work Orders were issued in February 2009 due to unapproved plans and March 2009 for failure to provide guard rails around the floor openings. In October 2009 excavation of the backyard for a rear extension was halted due to failure to provide protection at the sides of the excavation, which was 8 feet deep.
Project Type: Existing building alteration
Project Description: Vertical enlargement, adding additional floor to 3 story, 6 family apartment building
Status: Partial Stop Work Order in effect
UPDATE: DOB adds to "Stalled Sites" list for extra monitoring: 2/16/2010
Background: Plans were filed in 2008 to add an additional floor. Gut renovations were undertaken. Violations were issued for unsafe working conditions. Inspectors noted men working on open flooring throughout the site, floors exposed and with no safety equipment. Stop Work Orders were issued in February 2009 due to unapproved plans and March 2009 for failure to provide guard rails around the floor openings. In October 2009 excavation of the backyard for a rear extension was halted due to failure to provide protection at the sides of the excavation, which was 8 feet deep.
359 3rd Avenue, Gowanus
(between 1st and 3rd Streets)
Project type: Demolition, planned development site
Project description: Demolition of idle Con Edison building; planned for future development (no immediate plans)
Status: Portion of site in use; demo delayed but scaffolding installed late 2009
UPDATE: DOB adds to "Stalled Sites" list for extra monitoring: 2/16/2010
Background: Con Edison is demolishing a 1 story warehouse adjacent to its parking lot and plans to sell part or all of the property for development. Demolition permits were issued in mid-2009 but work did not proceed until early 2010. The site was where the Brooklyn Dodgers played in the late 19th and early 20th centuries, prior to building Ebbets Field. There is speculation that parts of the exterior wall are remnants of the Dodgers’ stadium, but others believe that the Dodgers’ stadium was fully demolished when the Dodgers left in 1912 and that the wall is from the stadium built for other teams shortly afterward. All agree that the site is important to baseball history, and Con Edison has promised to not demolish the historic wall.
In late December 2009 a sidewalk shed was erected. The adjacent parking lot is still actively used for Con Edison vehicles.
Project type: Demolition, planned development site
Project description: Demolition of idle Con Edison building; planned for future development (no immediate plans)
Status: Portion of site in use; demo delayed but scaffolding installed late 2009
UPDATE: DOB adds to "Stalled Sites" list for extra monitoring: 2/16/2010
Background: Con Edison is demolishing a 1 story warehouse adjacent to its parking lot and plans to sell part or all of the property for development. Demolition permits were issued in mid-2009 but work did not proceed until early 2010. The site was where the Brooklyn Dodgers played in the late 19th and early 20th centuries, prior to building Ebbets Field. There is speculation that parts of the exterior wall are remnants of the Dodgers’ stadium, but others believe that the Dodgers’ stadium was fully demolished when the Dodgers left in 1912 and that the wall is from the stadium built for other teams shortly afterward. All agree that the site is important to baseball history, and Con Edison has promised to not demolish the historic wall.
In late December 2009 a sidewalk shed was erected. The adjacent parking lot is still actively used for Con Edison vehicles.
Saturday, May 22, 2010
85 3rd Street, Carroll Gardens
(between Hoyt and Bond Streets)
Project Type: New Building
Project Description: Construction Of a 5 Story 6 Unit Building
Status: Building infrastructure partially complete (open in front and back)
UPDATE: DOB declared "Stalled" 5/12/2010. Site in dangerous condition. Section of fence is down, providing easy access to site and exposure to unprotected pit. Violation for defective fence and expiration of fence permit 5/12/10.
Blog reader addition!
Project Type: New Building
Project Description: Construction Of a 5 Story 6 Unit Building
Status: Building infrastructure partially complete (open in front and back)
UPDATE: DOB adds to "Stalled Sites" list for extra monitoring: 5/10/2010
Background: In early 2007 the applicant filed for construction of a new 5 story building and demolition of the existing 2 story (plus cellar) home. However, they subsequently withdrew the application for the new building, and in September 2007 they filed a new application for an alteration to the existing building – adding two floors on top of the existing two floor building. This would have added 4,500 square feet to the existing 2,100 sf building, creating a total floor area of 6,630 sf.
Work began in June 2008, but a Stop Work Order was served in July; though the SWO was rescinded soon after, other violations were issued throughout the project for conditions such as excessive construction debris, inadequate plywood fencing that made the site accessible; expired fence permits, exposed electrical wiring, and unprotected excavation without shoring or bracing walls.
Neighbors reported that the building was being demolished and entirely gutted, but the DOB reported that the work was within the scope of the alteration plans.
As of our visit in March 2010, the building is open in the front and rear, with partial cement side walls and steel infrastructure. Neighbors report that there has been no activity for months, and that water is collecting and seeping into the adjacent property. There is construction debris in the front area, but the fencing is in place. It’s not possible to see the condition of the excavation in the rear.
Background: In early 2007 the applicant filed for construction of a new 5 story building and demolition of the existing 2 story (plus cellar) home. However, they subsequently withdrew the application for the new building, and in September 2007 they filed a new application for an alteration to the existing building – adding two floors on top of the existing two floor building. This would have added 4,500 square feet to the existing 2,100 sf building, creating a total floor area of 6,630 sf.
Work began in June 2008, but a Stop Work Order was served in July; though the SWO was rescinded soon after, other violations were issued throughout the project for conditions such as excessive construction debris, inadequate plywood fencing that made the site accessible; expired fence permits, exposed electrical wiring, and unprotected excavation without shoring or bracing walls.
Neighbors reported that the building was being demolished and entirely gutted, but the DOB reported that the work was within the scope of the alteration plans.
As of our visit in March 2010, the building is open in the front and rear, with partial cement side walls and steel infrastructure. Neighbors report that there has been no activity for months, and that water is collecting and seeping into the adjacent property. There is construction debris in the front area, but the fencing is in place. It’s not possible to see the condition of the excavation in the rear.
Monday, March 15, 2010
22 Caton Place, Kensington
(between Ocean Parkway and East 8th Street)
Project Type: New building
Project Description: Construction of a new 7 story, 58 unit building
Status: Fenced lot. No activity.
UPDATE 3/15/2010: DOB added to "Stalled Sites" list for extra monitoring
Background: Demolition of the previous building was started in 2005. Numerous violations were incurred during the demolition phase, citing non-compliant and damaged fencing, and failure to properly store combustible materials. The developer sought an upzoning from R6 to R7A to enable construction of an 8-story building. There was significant neighborhood opposition. Community Board 7 voted unanimously to disapprove the ULURP application, and the Borough President disapproved the application, recommending R7B instead. City Planning approved the R7B designation, and the developer modified his plans. Plans for a new building were filed in 2007. The design was by architect Karl Fischer.
The developer had difficulties obtaining financing. The site remained idle while permits expired and the job site fence continued to deteriorate. As of late 2009 there were 8 open violations and there is considerable debris on the lot. There is no activity but the site has not been declared as stalled.
Project Type: New building
Project Description: Construction of a new 7 story, 58 unit building
Status: Fenced lot. No activity.
UPDATE 3/15/2010: DOB added to "Stalled Sites" list for extra monitoring
Background: Demolition of the previous building was started in 2005. Numerous violations were incurred during the demolition phase, citing non-compliant and damaged fencing, and failure to properly store combustible materials. The developer sought an upzoning from R6 to R7A to enable construction of an 8-story building. There was significant neighborhood opposition. Community Board 7 voted unanimously to disapprove the ULURP application, and the Borough President disapproved the application, recommending R7B instead. City Planning approved the R7B designation, and the developer modified his plans. Plans for a new building were filed in 2007. The design was by architect Karl Fischer.
The developer had difficulties obtaining financing. The site remained idle while permits expired and the job site fence continued to deteriorate. As of late 2009 there were 8 open violations and there is considerable debris on the lot. There is no activity but the site has not been declared as stalled.
Sunday, March 14, 2010
231-233 Ocean Parkway, Kensington
(between Church Avenue & Beverly Road)
Blog reader addition
Project Type: New Building
Project Description: Demolition of house and garage; Construction of 8 story, 12 unit residential building with below-grade parking
Status: Update 714/10: Portion of fenced collapsed.
Vacant Lot, Excavation backfilled, DOB “Stalled” classification
Background: In early 2008 plans began for demolition of a home and garage and construction of a new 8 story building. During demolition and excavation, there were numerous complaints and violations concerning defective and missing fencing.
The site was idle, permits expired in April 2009, and in July 2009 the DOB declared it as a Stalled Site.
In September 2009 the DOB filed an Emergency Declaration noting that the partial foundation had inadequate bracing and water had not been drained. The DOB ordered it backfilled to grade. The owner did not comply, so the city backfilled the excavation and installed a chain link fence.
As of an early March 2010 DOB inspection and our site visit, the lot was graded and fenced, with no activity.
Project Description: Demolition of house and garage; Construction of 8 story, 12 unit residential building with below-grade parking
Status: Update 714/10: Portion of fenced collapsed.
Vacant Lot, Excavation backfilled, DOB “Stalled” classification
Background: In early 2008 plans began for demolition of a home and garage and construction of a new 8 story building. During demolition and excavation, there were numerous complaints and violations concerning defective and missing fencing.
The site was idle, permits expired in April 2009, and in July 2009 the DOB declared it as a Stalled Site.
In September 2009 the DOB filed an Emergency Declaration noting that the partial foundation had inadequate bracing and water had not been drained. The DOB ordered it backfilled to grade. The owner did not comply, so the city backfilled the excavation and installed a chain link fence.
As of an early March 2010 DOB inspection and our site visit, the lot was graded and fenced, with no activity.
217-225 4th Avenue, Park Slope
(between President Street & Union Street)
Blog reader addition!
Project Type: New Building
Project Description: Construction of a 12 story, 40 unit condo building
Status: Vacant lot, Idle
Background: In 2000 the owner of the Brooklyn Lyceum – a former bath house turned into an arts and event space – and his business partner (Jean Miele, an architect), planned to build a new building on the adjacent lot. Due to financial difficulties, the Lyceum owner defaulted on his stake in the vacant lot, and ownership for the lot reverted to Miele. Miele decided to go ahead on his own, and in February 2008 he filed plans for construction of a 12 story, 40 unit, 61,000 sf condo building. The site was cleared in 2008 (including removal of a historic trolley car); excavation was initiated and then halted. There has been no apparent activity since then.
A website indicates that the owners are seeking development partners “to create a dynamic enclave tower of arts, commerce and residences.”
192 East 5th Street, Kensington
(SW corner of Caton Avenue, formerly 417 Caton Avenue)
Blog reader addition!
Project Type: New Building
Project Description: Demolition of home and garage and construction of a pair of new homes
Status: Vacant Lot, Idle
Background: Two 2 story homes were bought and demolished in 2003, and the lots were merged. The demolition was left incomplete through 2003 and 2004, and there were numerous complaints and violations citing unsafe conditions. Part of one floor remained standing, debris and combustible material accumulated in front, and the plywood fence fell multiple times, leaving the site open and unguarded. A new owner acquired the site in 2005 and completed the demolition, and in they filed plans for the construction of two 3 story condo buildings designed by architect Henry Radusky.
No construction activity has taken place. The fence has been in disrepair during periods and neighbors reported that children were playing on the site, but as of our site visit in early March the fence is now secure and the lot is cleared.
103-105 Kane Street, Columbia Waterfront District
(between Columbia Street & Tiffany Place)
Blog reader addition!
Project Type: New Building
Project Description: Construction of a 5-story 7 unit residential building with community facility
Status: Vacant Lot
Background: In early 2008, plans were filed for a 5 story building with a community facility. The zoning (R6) at the time allowed for bonus floor area (based on height or bulk) if a community facility is provided (though “community facility” is broadly defined to include medical offices); using that bonus, the developer filed for a 5 story, 16,000 square foot building, with a Floor Area Ratio (FAR) of about 4.0. Excavation was initiated in June 2008.
The Carroll Gardens/Columbia Waterfront Contextual Rezoning would have only allowed for a FAR of 3.0. The DOB inspected the site and determined that the foundation was not started, and a Stop Work Order was issued.
The site is idle, though not “stalled” under the DOB classification. The covering on the front fence is poorly maintained, but the fence is intact, the lot is in reasonably good condition, and there have not been complaints or violations.
75 Columbia Street, Columbia Waterfront District
(NE corner of Columbia and Warren)
Blog reader addition!
Project Type: New Building
Project Description: Demo of commercial building; Construction of a 6 story 10 unit residential building
Status: Vacant lot, partially excavated
Background: On this corner lot, a one-story warehouse – vacant since at least 2006 – was bought for demolition and the construction of a new residential condo building. Planning began in 2007/2008, with demolition permits approved in January 2008 and underway later in the year.
On 9/15/2008, a Stop Work Order was issued during the demolition phase, as inspectors reported that there were no detailed plans for shoring the walls of the excavation so it wouldn’t damage an adjacent building. Guardrails were also not present to protect workers from the excavation. Limited work was permitted to proceed to install safety equipment.
In November 2008, the contractor presented amended plans, and guardrails were installed. The site was determined to be in safe condition and the SWO was rescinded.
The Carroll Gardens/Columbia Waterfront Contextual Rezoning, which was in development at this time, may have allowed for the height but not the bulk. The building plan was for a 6 story, nearly 20,000 sf building, with a Floor Area Ratio (FAR) of about 3.7. The maximum FAR under the new zoning is 3.0. Some other nearby developments were also stopped by the rezoning, though a couple of large ones had progressed far enough that they were allowed to proceed with plans that would have otherwise been out of compliance. This site had not advanced sufficiently and would have to be modified before proceeding.
Currently there is plywood fencing around the site. Inside, there is a dirt pit from the incomplete excavation, along with lumber, other debris and plant overgrowth. There is no current activity, permits are expired and the site is for sale.
277 1st Street, Park Slope
(between 4th Avenue & 5th Avenue)
Blog reader addition!
Project Description: Originally planned a 4 story 2 unit building (1999); new plan for a 4 story 5 unit building (2002)
Status: Building Infrastructure Partially Complete
Background: This project was initiated in 1999 but was significantly expanded in 2003. The 1999 plan was for a new 4 story, 2 unit, 4,000 sf building. The plans were withdrawn in 2003 and new plans were filed to build a 4 story, 14,000 sf building by merging adjacent lots. The plans refer to 3 units, but they may mean 3 units per original lot, thus totaling 9 units.
The Park Slope Rezoning halted work, but the DOB determined that it was sufficiently far along to proceed under the previous rules.
There have been several major safety violations:
- 2004: In May a violation was issued for failure to protect public and property affected by construction operations. The violation noted that one side of the excavation fence and a portion of the side yard had collapsed due to improper sheeting and shoring of the excavation and foundation. In June a violation was issued for failure to provide protection of sides of an excavation approximately 15 feet long in front of the building. In November a violation was issued for failure to provide protection at the side of excavation. Protection was not provided, and along one wall there was no sheeting, shoring or bracing. A Stop Work Order was issued.
- 2005: In May a violation was issued for work contrary to approved DOB plans; a crane was hoisting steel in the wrong position. The contractor also failed to have a permit signed off by an engineer. In December a violation was issued due to the lack of a sidewalk shed. The inspector noted that steel framing for the new building of approximately 50 feet in height had been erected without a sidewalk shed for protection of pedestrians on sidewalk. A Stop Work Order was issued.
- 2007: In March a violation was issued because the sidewalk shed did not meet building code specifications. The shed was missing lighting and a deck enclosure.
- 2008: In February a violation was issued for lack of guardrails along an opening on the roof terrace.
- 2010: In February another violation was issued because the sidewalk shed did not meet DOB code requirements. It was missing a parapet on the top of shed.
Permits are still active.
The building has 4 full floors and a fifth floor that may be a terrace or other structure.
187 7th Avenue, Park Slope
(NE corner of 7th Avenue and 2nd Street; aka 501 2nd Street and 495-505 2nd Street)
Blog reader addition!
Project Description: None (vacant building)
Status: Sealed, Vacant Building
Background: This classic Park Slope building was known mostly for the ground floor “Landmark Pub.” The pub closed in the late 1990s and the façade and apartments above fell into disrepair. Since 2003 there has been a steady stream of complaints and violations about the failure to maintain the building and deteriorating conditions. Reports indicate that window frames were splintered and that glass was broken and at risk of falling on the sidewalk.
The city erected an emergency sidewalk shed in 2007, but there were reports throughout 2008 and 2009 that the sidewalk shed was not being adequately maintained and was in Disrepair. Metal bars on the sidewalk shed were bent or missing, and there was a gap between the shed and the building.
In May 2009 then-Councilmember De Blasio intervened to get the sidewalk shed repaired. By January 2010, conditions had deteriorated again, the shed was in disrepair.
There are no active permits for the shed, and the building remains sealed.
Friday, February 5, 2010

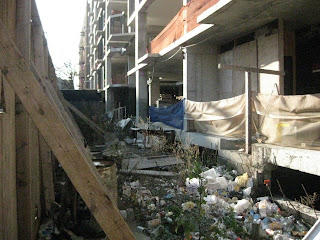

23 Caton Place, Kensington
(between Ocean Parkway & East 8th Street)
Project Type: New Building
Project Description: New Building, 8 Stories, 107 Units
Status: Partially finished building skeleton, stalled
UPDATE 8/2010: ECB violation for obstructed exits, building fined 4,000 on August 2nd. Unresolved.
UPDATE 3/15/2010: Contractor has done remedial work to clean and make site safe
Background: “Caton on the Park,” planned since 2004 and designed by architect Karl Fischer, has drawn considerable attention as emblematic of out-of-context development and the stalled construction issue. Community groups considered it to be too large for the local neighborhood, which is generally characterized by one- and two-family homes. The building elicited neighborhood protests and was a factor in the community seeking a contextual rezoning (approved in spring 2009).
From early on, there were numerous complaints about impact to neighboring properties, site safety and after-hours work. Multiple Stop Work Orders were issued – December 2005 because adjacent properties were not protected from the demolition work, September 2006 because the construction was not compliant with approved plans, February 2008 because of further damage to adjacent properties, and April 2008, when debris was ordered to be removed and an a construction fence be repaired or installed. The DOB determined the building was 40% completed.
Cost overruns and market conditions caused financing problems. In June 2008 the lender filed to foreclose on the property, and in August the mezzanine lender filed for bankruptcy. Corus Bank, which made the original mortgage loan, failed and that the debt has been sold to Starwood Capital Group, which has been maintaining the site but not yet indicated its longer-term plans. As of December 2009, the site had 52 active violations, and there was a new set of permits for remedial measures to make the site safe.
Project Type: New Building
Project Description: New Building, 8 Stories, 107 Units
Status: Partially finished building skeleton, stalled
UPDATE 8/2010: ECB violation for obstructed exits, building fined 4,000 on August 2nd. Unresolved.
UPDATE 3/15/2010: Contractor has done remedial work to clean and make site safe
Background: “Caton on the Park,” planned since 2004 and designed by architect Karl Fischer, has drawn considerable attention as emblematic of out-of-context development and the stalled construction issue. Community groups considered it to be too large for the local neighborhood, which is generally characterized by one- and two-family homes. The building elicited neighborhood protests and was a factor in the community seeking a contextual rezoning (approved in spring 2009).
From early on, there were numerous complaints about impact to neighboring properties, site safety and after-hours work. Multiple Stop Work Orders were issued – December 2005 because adjacent properties were not protected from the demolition work, September 2006 because the construction was not compliant with approved plans, February 2008 because of further damage to adjacent properties, and April 2008, when debris was ordered to be removed and an a construction fence be repaired or installed. The DOB determined the building was 40% completed.
Cost overruns and market conditions caused financing problems. In June 2008 the lender filed to foreclose on the property, and in August the mezzanine lender filed for bankruptcy. Corus Bank, which made the original mortgage loan, failed and that the debt has been sold to Starwood Capital Group, which has been maintaining the site but not yet indicated its longer-term plans. As of December 2009, the site had 52 active violations, and there was a new set of permits for remedial measures to make the site safe.
Thursday, February 4, 2010
385 4th Avenue, Park Slope
(between 6th and 7th Streets)
Project Type: New building
Project Description: Construction of new 11 story 51 unit residential building
Status: Stalled construction site; vacant lot
Background: This site was bought by controversial landlord Baruch Singer, who has specialized in buying distressed properties. He has sought to develop major new buildings, for example as co-investor of the Greenpoint Pencil Factory condo. In 2006, Singer bought this property in the South Slope and planned to develop an 11-story condo building. Singer hit financial trouble; in 2008 he renegotiated terms with the lender for this property, and subsequently the lender for the Pencil Factory called in its loan because that building wasn’t finished by its scheduled completion date.
The 4th Avenue project was declared Stalled in April 2009. The excavation was backfilled. Permits, which were renewed in mid-2009, expired in January 2010. There is no current activity, and the DOB considers the site secure and safe.
Project Type: New building
Project Description: Construction of new 11 story 51 unit residential building
Status: Stalled construction site; vacant lot
Background: This site was bought by controversial landlord Baruch Singer, who has specialized in buying distressed properties. He has sought to develop major new buildings, for example as co-investor of the Greenpoint Pencil Factory condo. In 2006, Singer bought this property in the South Slope and planned to develop an 11-story condo building. Singer hit financial trouble; in 2008 he renegotiated terms with the lender for this property, and subsequently the lender for the Pencil Factory called in its loan because that building wasn’t finished by its scheduled completion date.
The 4th Avenue project was declared Stalled in April 2009. The excavation was backfilled. Permits, which were renewed in mid-2009, expired in January 2010. There is no current activity, and the DOB considers the site secure and safe.
Wednesday, February 3, 2010
559 Carroll Street, Park Slope
(between 4th and 5th Avenues)
Project Type: New building
Project Description: Construction of new 4 story residential building
Status: Undermined adjacent building; Stop Work Order issued; site backfilled, rakers and foot blocks installed; Declared stalled 12/10/2009.
Background: Plans for this 4 story residential building were initiated in 2007. A stop work order was issued in March 2008 because an adjacent building was undermined by the underpinnings operation. Remedial actions included drypack underpinning and the installation of rakers and heel blocks in support of the rakers. Subsequently, a violation was issued because there was no protection at the sides of the excavation.
The site was declared stalled in December 2009 and an emergency declaration was issued because the excavation was still undermining the adjacent property and the walls were bulging. The Emergency Declaration required that the excavation be backfilled. HPD reported that the owner was complying.
The site was declared stalled in December 2009 and an emergency declaration was issued because the excavation was still undermining the adjacent property and the walls were bulging. The Emergency Declaration required that the excavation be backfilled. HPD reported that the owner was complying.
As of early February 2010, the site was backfilled, graded and fenced, and rakers whalers and heel locks were installed for temporary shoring to the adjoining property. The DOB reported that there is no immediate threat.
Tuesday, February 2, 2010

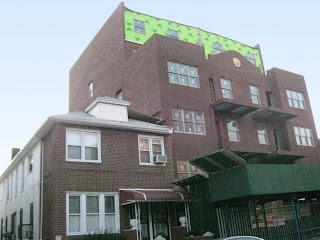

960 50th Street, Borough Park
(between 9th and 10th Avenues)
Project Type: New building
Project Description: Demolition of a house and garage and construction of a new 5 story, 8 unit residential building
Status: Update 8/2010: No application on file for lighting power 7/23/10.
Proceeding
Background: Plans were filed in 2007 to build a new 5 story residential buidling. A Full Stop Work Order was issued in November 2008 because the excavation was causing damage to an adjacent property. The contractor was allowed to shore up and the foundation was pour a concrete foundation, the SWO was lifted in December. Additional SWOs were issued – February 2009 due to inadequate fencing to prevent public access to the excavation, and May 2009 because of additional site safety problems, including site fence defects and missing guardrails and handrails around the excavation. A violation was issued in October due to lack of permits for scaffolding at the top floor.
Permits were renewed in December 2009, and the building exterior is nearly complete.
Project Type: New building
Project Description: Demolition of a house and garage and construction of a new 5 story, 8 unit residential building
Status: Update 8/2010: No application on file for lighting power 7/23/10.
Proceeding
Background: Plans were filed in 2007 to build a new 5 story residential buidling. A Full Stop Work Order was issued in November 2008 because the excavation was causing damage to an adjacent property. The contractor was allowed to shore up and the foundation was pour a concrete foundation, the SWO was lifted in December. Additional SWOs were issued – February 2009 due to inadequate fencing to prevent public access to the excavation, and May 2009 because of additional site safety problems, including site fence defects and missing guardrails and handrails around the excavation. A violation was issued in October due to lack of permits for scaffolding at the top floor.
Permits were renewed in December 2009, and the building exterior is nearly complete.
900 Coney Island Avenue, Kensington
(between Ditmas Avenue and 18th Avenue)
Background: A small building housing a commercial storefront (currently Domino’s Pizza) and apartments was slated for a major expansion up and back, adding a 6 story commercial and community facility. The first permits were filed in 2001, but there was a gap of 5 years until zoning lots were combined and a new round of permits were filed. In the interim, a violation was issued for the operation of a school on the second floor of the existing building. Also in the interim, the owner filed for bankruptcy and his real estate holdings were contested by his spouse.
Work was resumed in 2006. The shell of the expansion was constructed, but a Stop Work Order was issued in October 2007 due to failure to protect the roof of an adjacent property. Though repairs were made and the SWO was rescinded in November 2007, work ceased and the permits expired in December 2007. There is no evidence of subsequent activity. The Domino’s is open, and the new section remains incomplete. The site was declared Stalled in June 2009. The DOB reports that there is no immediate threat.
Project Type: Alteration/new building
Project Description: Alteration of a store & apartments to commercial & community facility; four story horizontal & vertical extensions (behind Domino's Pizza)
Status: Update 8/2010: violation issued for warped cellar doors 5/4/10.
Empty shell
Project Description: Alteration of a store & apartments to commercial & community facility; four story horizontal & vertical extensions (behind Domino's Pizza)
Status: Update 8/2010: violation issued for warped cellar doors 5/4/10.
Empty shell
Background: A small building housing a commercial storefront (currently Domino’s Pizza) and apartments was slated for a major expansion up and back, adding a 6 story commercial and community facility. The first permits were filed in 2001, but there was a gap of 5 years until zoning lots were combined and a new round of permits were filed. In the interim, a violation was issued for the operation of a school on the second floor of the existing building. Also in the interim, the owner filed for bankruptcy and his real estate holdings were contested by his spouse.
Work was resumed in 2006. The shell of the expansion was constructed, but a Stop Work Order was issued in October 2007 due to failure to protect the roof of an adjacent property. Though repairs were made and the SWO was rescinded in November 2007, work ceased and the permits expired in December 2007. There is no evidence of subsequent activity. The Domino’s is open, and the new section remains incomplete. The site was declared Stalled in June 2009. The DOB reports that there is no immediate threat.

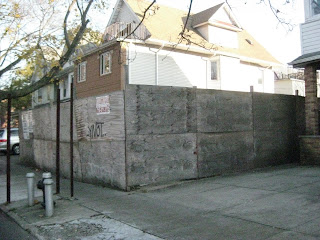

716 Ditmas Avenue, Kensington
(between East 7th and East 8th Streets)
Project Type: New building
Project Description: Construction of a new 3 story house of worship
Status: Vacant lot, no activity
Update 8/2010: tree debris on sidewalk preventing pedestrian access 6/22/10.
Background: Plans in 2003 indicate that a 2 story residence was going to be enlarged in the rear and converted into a facility for Congregation Tifereth Tomor Dvora Sfard, a Sephardic congregation on Ocean Parkway. It’s unclear whether or not the planned work was done, but in 2006 permits for a larger expansion (horizontal and vertical) were disapproved, and in 2008 the building was demolished. Plans for construction of a new 3 story synagogue were approved. Construction equipment was brought on site but no significant work was done, and now exists as a fenced, vacant lot.
The site was declared Stalled in July 2009. The mortgage owner, First Central Savings Bank, became insolvent, and in September 2009 Wachovia assumed ownership of the mortgage. As of December, all permits were expired, a tractor and construction equipment were on the site, and there was no activity.
Project Type: New building
Project Description: Construction of a new 3 story house of worship
Status: Vacant lot, no activity
Update 8/2010: tree debris on sidewalk preventing pedestrian access 6/22/10.
Background: Plans in 2003 indicate that a 2 story residence was going to be enlarged in the rear and converted into a facility for Congregation Tifereth Tomor Dvora Sfard, a Sephardic congregation on Ocean Parkway. It’s unclear whether or not the planned work was done, but in 2006 permits for a larger expansion (horizontal and vertical) were disapproved, and in 2008 the building was demolished. Plans for construction of a new 3 story synagogue were approved. Construction equipment was brought on site but no significant work was done, and now exists as a fenced, vacant lot.
The site was declared Stalled in July 2009. The mortgage owner, First Central Savings Bank, became insolvent, and in September 2009 Wachovia assumed ownership of the mortgage. As of December, all permits were expired, a tractor and construction equipment were on the site, and there was no activity.
561 11th Street, Park Slope
(between 7th and 8th Avenues)
Project Type: New building
Project Description: Demolition of a 2 story residential building and garage and construction of a new 4 story 4-unit building
Status: Proceeding, nearing completion
Background: Demolition was undertaken in 2008 and plans were filed for a new residential building. A violation was issued in February 2009 for the lack of guardrails around the perimeter of the second floor, and a partial Stop Work Order was issued in April 2009 because there was no overhead protection at the entrance of the job site and no roof protection provided for adjacent properties. The safety measures were installed quickly and the SWO rescinded, but another partial SWO was issued in August because the workers using the scaffolding were not qualified. As of January 2010 the building was mostly complete and construction was proceeding.
Project Type: New building
Project Description: Demolition of a 2 story residential building and garage and construction of a new 4 story 4-unit building
Status: Proceeding, nearing completion
Background: Demolition was undertaken in 2008 and plans were filed for a new residential building. A violation was issued in February 2009 for the lack of guardrails around the perimeter of the second floor, and a partial Stop Work Order was issued in April 2009 because there was no overhead protection at the entrance of the job site and no roof protection provided for adjacent properties. The safety measures were installed quickly and the SWO rescinded, but another partial SWO was issued in August because the workers using the scaffolding were not qualified. As of January 2010 the building was mostly complete and construction was proceeding.

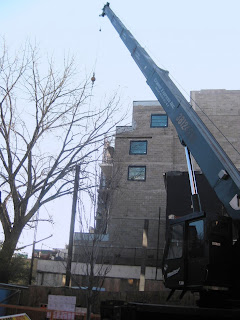

527 Court Street, Carroll Gardens
(between Garnet and West 9th Street)
Project Type: New building
Project Description: Demolition of 3 story building and construction of new 7 story, 18 unit building
Status: Proceeding
Background: This building was started in 2007. Multiple Stop Work Orders were issued throughout the history of the project. A Stop Work Order for the New Building was issued in April 2008 and violations were served for failure to protect people and properties affected by the demolition. Demolition was allowed to proceed. A full Stop Work Order in September 2008 cited failure to protect adjacent buildings during the demolition and excavation, inadequate means of exiting the excavation (10 feet deep), lack of guard rails around the excavation and hanging electrical wires, and the excavation was dug into the adjacent property. Additionally, the construction fence was found to be inadequate and the site was not properly secured. After a violation for failure to comply with the SWO, remedial safety measures we
re undertaken and the SWO was lifted in October 2008. Another SWO was issued in April 2009 due to lack of handrails throughout the site and guardrails at various locations, and an SWO was issued in June 2009 for failure to extend the chimney to protect adjacent roofs. This SWO was rescinded in December, but less than one week later an SWO was issued due to inadequate scaffolding and the lack of a licensed rigger. As of the end of December, the SWOs had been rescinded and the building was nearing completion.
Project Type: New building
Project Description: Demolition of 3 story building and construction of new 7 story, 18 unit building
Status: Proceeding
Background: This building was started in 2007. Multiple Stop Work Orders were issued throughout the history of the project. A Stop Work Order for the New Building was issued in April 2008 and violations were served for failure to protect people and properties affected by the demolition. Demolition was allowed to proceed. A full Stop Work Order in September 2008 cited failure to protect adjacent buildings during the demolition and excavation, inadequate means of exiting the excavation (10 feet deep), lack of guard rails around the excavation and hanging electrical wires, and the excavation was dug into the adjacent property. Additionally, the construction fence was found to be inadequate and the site was not properly secured. After a violation for failure to comply with the SWO, remedial safety measures we
re undertaken and the SWO was lifted in October 2008. Another SWO was issued in April 2009 due to lack of handrails throughout the site and guardrails at various locations, and an SWO was issued in June 2009 for failure to extend the chimney to protect adjacent roofs. This SWO was rescinded in December, but less than one week later an SWO was issued due to inadequate scaffolding and the lack of a licensed rigger. As of the end of December, the SWOs had been rescinded and the building was nearing completion.
455 Smith Street, Carroll Gardens
(between Luquer and Nelson Streets)
Project Type: Demolition / Development Site
Project Description: Demolition of warehouse; no known development plan
Status: Stalled Construction Site. Partial Stop Work Order in effect.
Background: The owners had planned to demolish an abandoned warehouse known as the Vichar/Abadhi warehouse, previously used by 47th Street Photo. In February 2009 multiple Stop Work Orders were issued due to the failure to provide a fence and overhead protection, the presence of flammable, combustible material during demolition, and the lack of an adequate site safety plan. The site was declared Stalled in April 2009, noting that the demolition was in progress. The site, which is adjacent to the Public Place development site, is contaminated due to prior industrial use. During the summer, the site was drilled for wells to remove oil contamination, while the partially demolished building continued to deteriorate.
In August 2009, major portions of the building collapsed. No one was injured, but parked vehicles were damaged by the falling debris, and asbestos dust was distributed. Demolition was expedited and debris removed. It was declared Stalled in October 2009. By the end of 2009, all demolition had been completed, the site was fenced, not graded.
Prior to any future use the land will have to be extensively remediated under New York State Department of Environmental Conservation supervision. There are no imminent development plans.
Project Type: Demolition / Development Site
Project Description: Demolition of warehouse; no known development plan
Status: Stalled Construction Site. Partial Stop Work Order in effect.
Background: The owners had planned to demolish an abandoned warehouse known as the Vichar/Abadhi warehouse, previously used by 47th Street Photo. In February 2009 multiple Stop Work Orders were issued due to the failure to provide a fence and overhead protection, the presence of flammable, combustible material during demolition, and the lack of an adequate site safety plan. The site was declared Stalled in April 2009, noting that the demolition was in progress. The site, which is adjacent to the Public Place development site, is contaminated due to prior industrial use. During the summer, the site was drilled for wells to remove oil contamination, while the partially demolished building continued to deteriorate.
In August 2009, major portions of the building collapsed. No one was injured, but parked vehicles were damaged by the falling debris, and asbestos dust was distributed. Demolition was expedited and debris removed. It was declared Stalled in October 2009. By the end of 2009, all demolition had been completed, the site was fenced, not graded.
Prior to any future use the land will have to be extensively remediated under New York State Department of Environmental Conservation supervision. There are no imminent development plans.
430 Carroll Street, Gowanus
(between 3rd Avenue and the Gowanus Canal)
Project Description: Development of sites along the Gowanus Canal
Project Type: Existing buildings and development site
Status: No activity. Sites for sale.
Background: Developer Shaya Boymelgreen and investors began planning Gowanus Village, a major residential development, in 2004. They bought three large parcels of land along the east side of the canal; two adjoining lots are between Carroll and 1st Streets, and the third is across the street on the 1st Street side. The site contained former manufacturing and industrial buildings, with prior uses that including a printing ink company, manufacturer of electrical equipment, a plumbing contractor, a truck storage facility, an auto repair facility, an auto wrecker, a sheet metal processor, an oil company and a storage facility. One of the remaining buildings was a historic red brick power station.
Boymelgreen hit financial trouble and was bought out by developer Isaac Katan and the original co-investors, Africa-Israel, which put the sites up for sale in early 2008. The buildings on the sites are deteriorating. A 2006 violation noted failure to maintain one of the buildings, which had hazardous conditions including bricks missing from the lintel above the garage door, the façade cracked and bulging, leaning brick columns and cracked mortar joints. Subsequent violations indicate that the defective conditions are continuing. The sites are not classified as Stalled.
Project Description: Development of sites along the Gowanus Canal
Project Type: Existing buildings and development site
Status: No activity. Sites for sale.
Background: Developer Shaya Boymelgreen and investors began planning Gowanus Village, a major residential development, in 2004. They bought three large parcels of land along the east side of the canal; two adjoining lots are between Carroll and 1st Streets, and the third is across the street on the 1st Street side. The site contained former manufacturing and industrial buildings, with prior uses that including a printing ink company, manufacturer of electrical equipment, a plumbing contractor, a truck storage facility, an auto repair facility, an auto wrecker, a sheet metal processor, an oil company and a storage facility. One of the remaining buildings was a historic red brick power station.
Boymelgreen hit financial trouble and was bought out by developer Isaac Katan and the original co-investors, Africa-Israel, which put the sites up for sale in early 2008. The buildings on the sites are deteriorating. A 2006 violation noted failure to maintain one of the buildings, which had hazardous conditions including bricks missing from the lintel above the garage door, the façade cracked and bulging, leaning brick columns and cracked mortar joints. Subsequent violations indicate that the defective conditions are continuing. The sites are not classified as Stalled.
Subscribe to:
Posts (Atom)
